Project Updates: Constructing the Glade
Renovating Steinberg Rink and creating the all-new Glade is a 20-month construction project transforming 22.5-acres between the Taylor Kindle River and Kingshighway.
Design of the Glade took four years and incorporated feedback from more than 6,000 members of our community. Work began in early 2025 thanks to the generosity of Forest Park Forever supporters who share our vision of all-season activity in eastern Forest Park.
Detours During Construction
Signs are posted at several points to indicate trail closures and detours. For everyone’s safety, do not enter the construction zone.

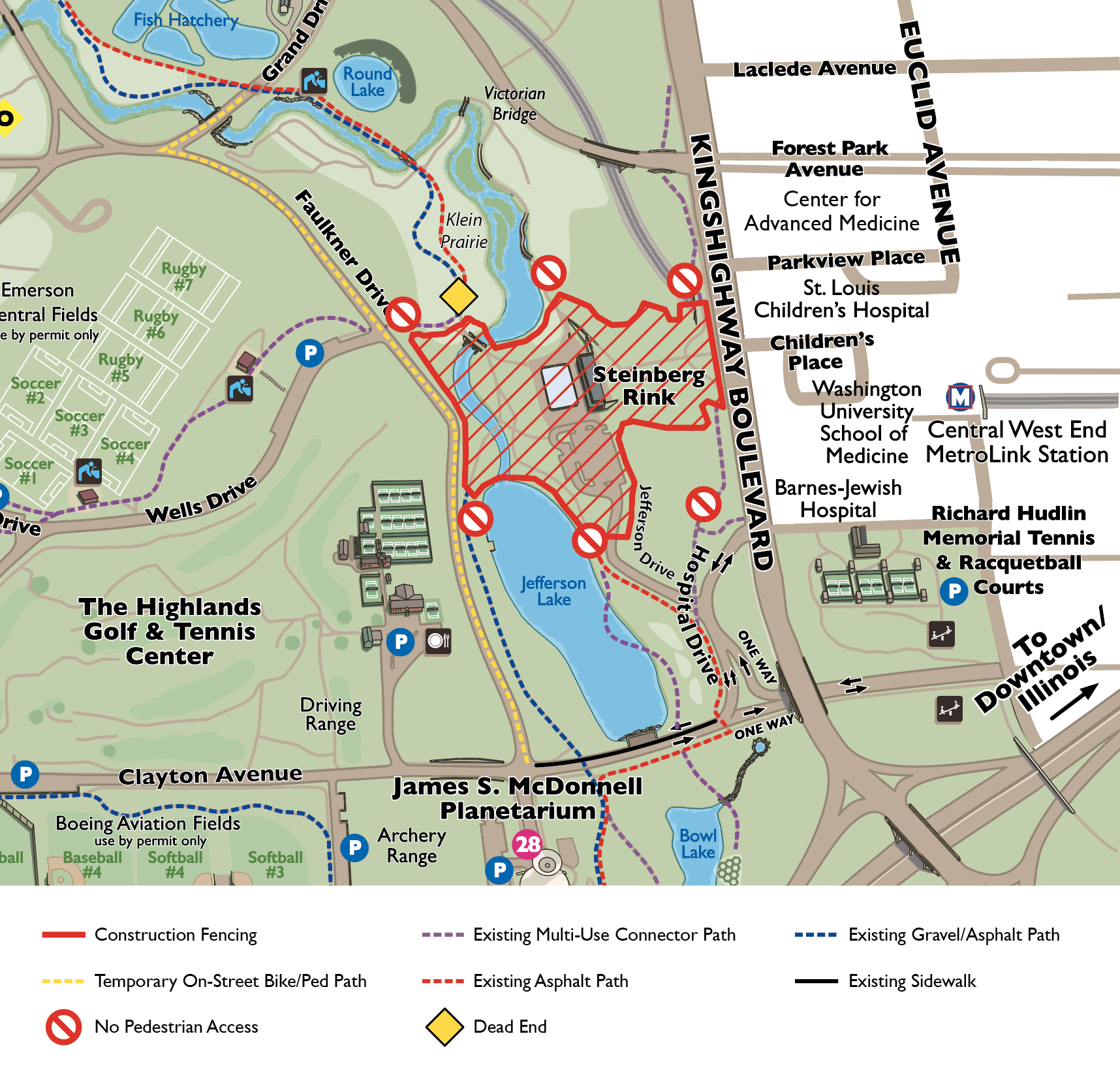

The gravel and asphalt pedestrian paths south of Klein Prairie are closed with detour signs to Faulkner Drive in place. Pedestrians and cyclists should follow detour signs to access the temporary pedestrian/cyclist-only lane on Faulkner Drive (shown in yellow on the map below).
Future Dual Path Relocation
To make room for the new community lawn and dual recreational path users, the paths will be routed across the Taylor Kindle River and follow along the river’s west side between Klein Prairie and Jefferson Lake (see rendering below).
Construction Highlights
-
We’ve made highly visible, exciting progress this spring and are on track to welcome ice skaters to the all-new, state-of-the-art Steinberg Rink this winter.

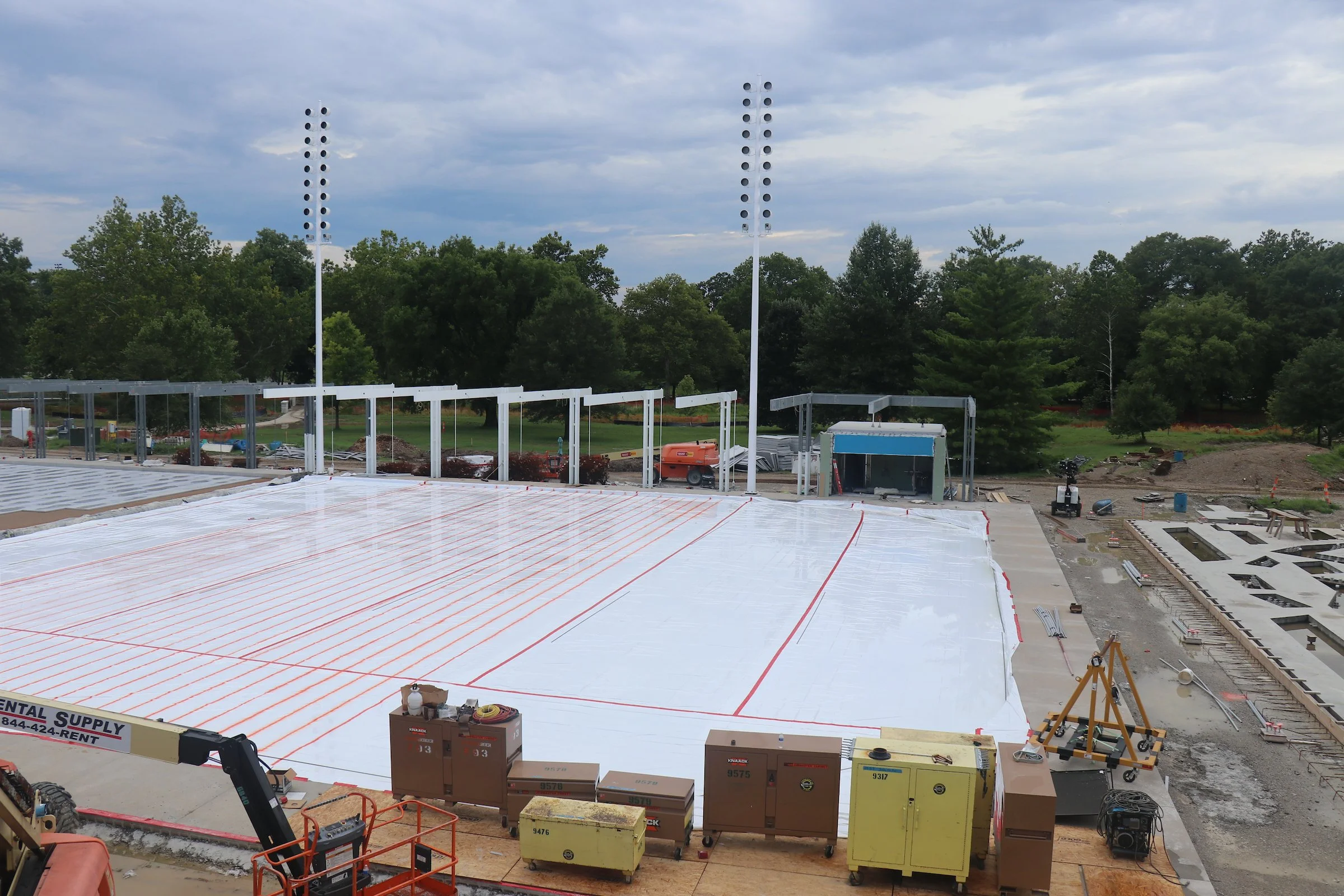

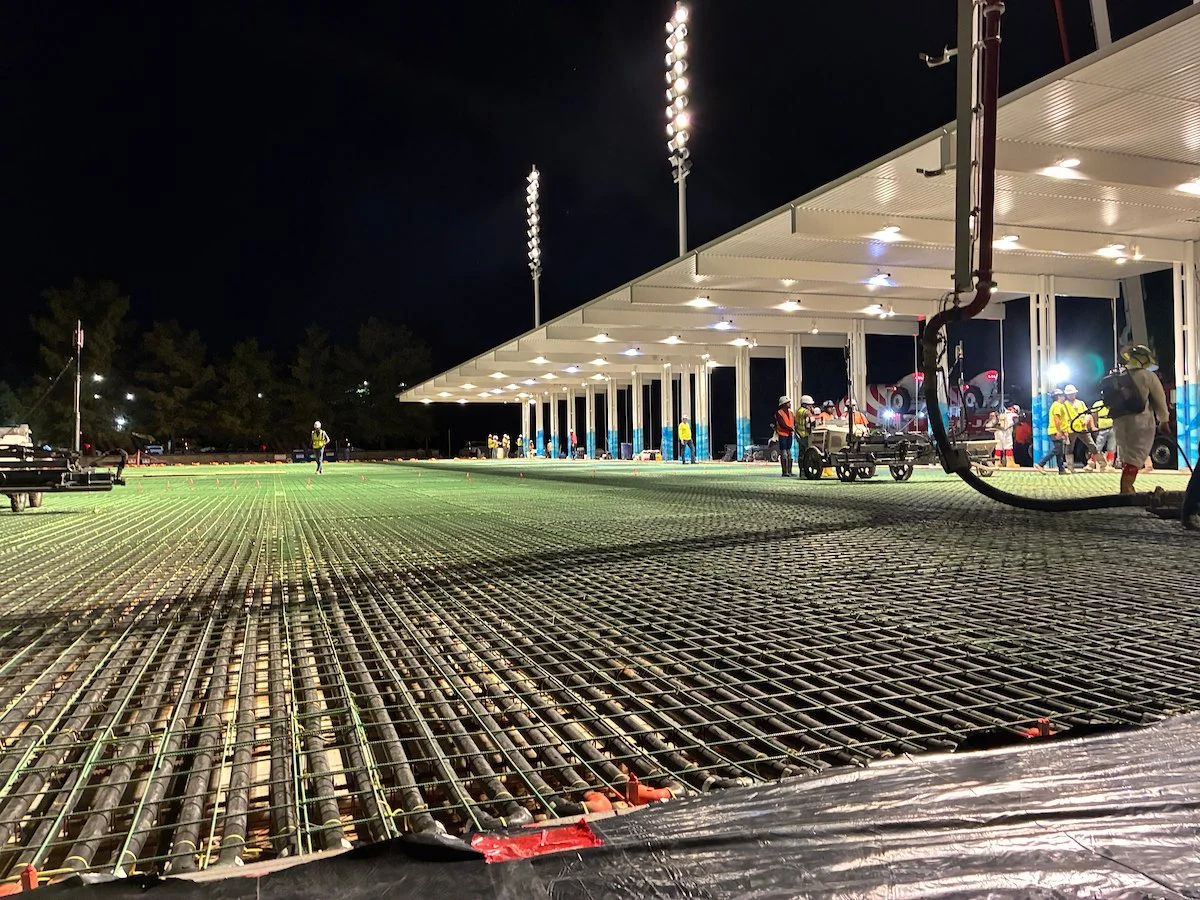

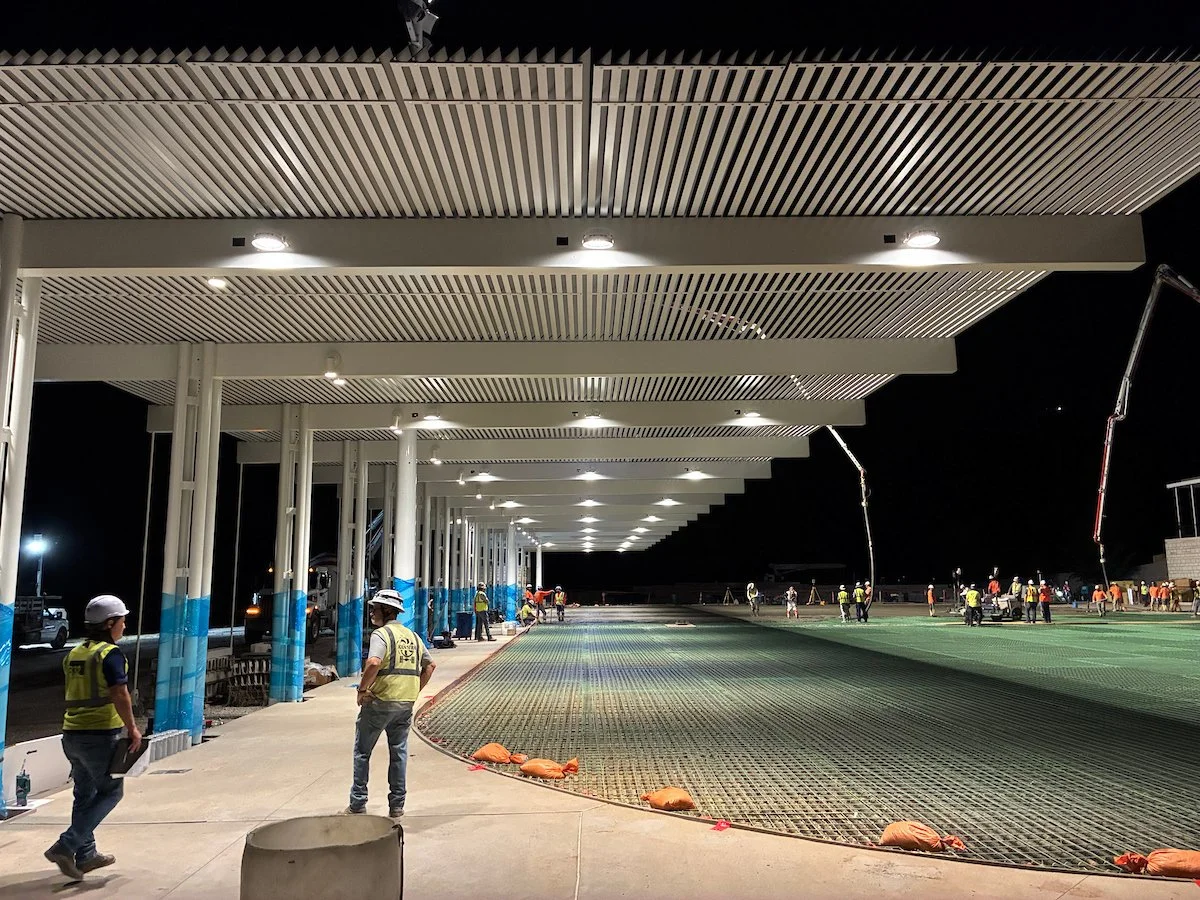

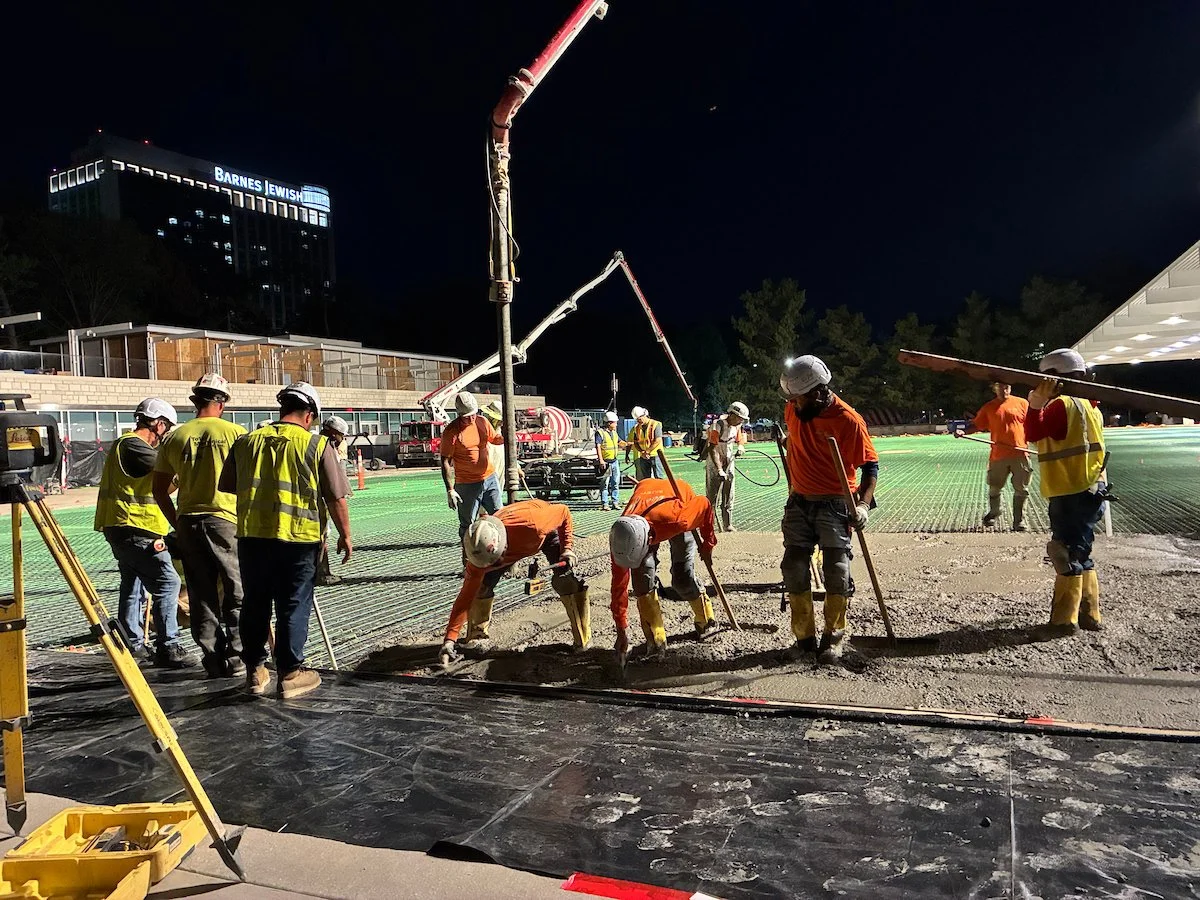

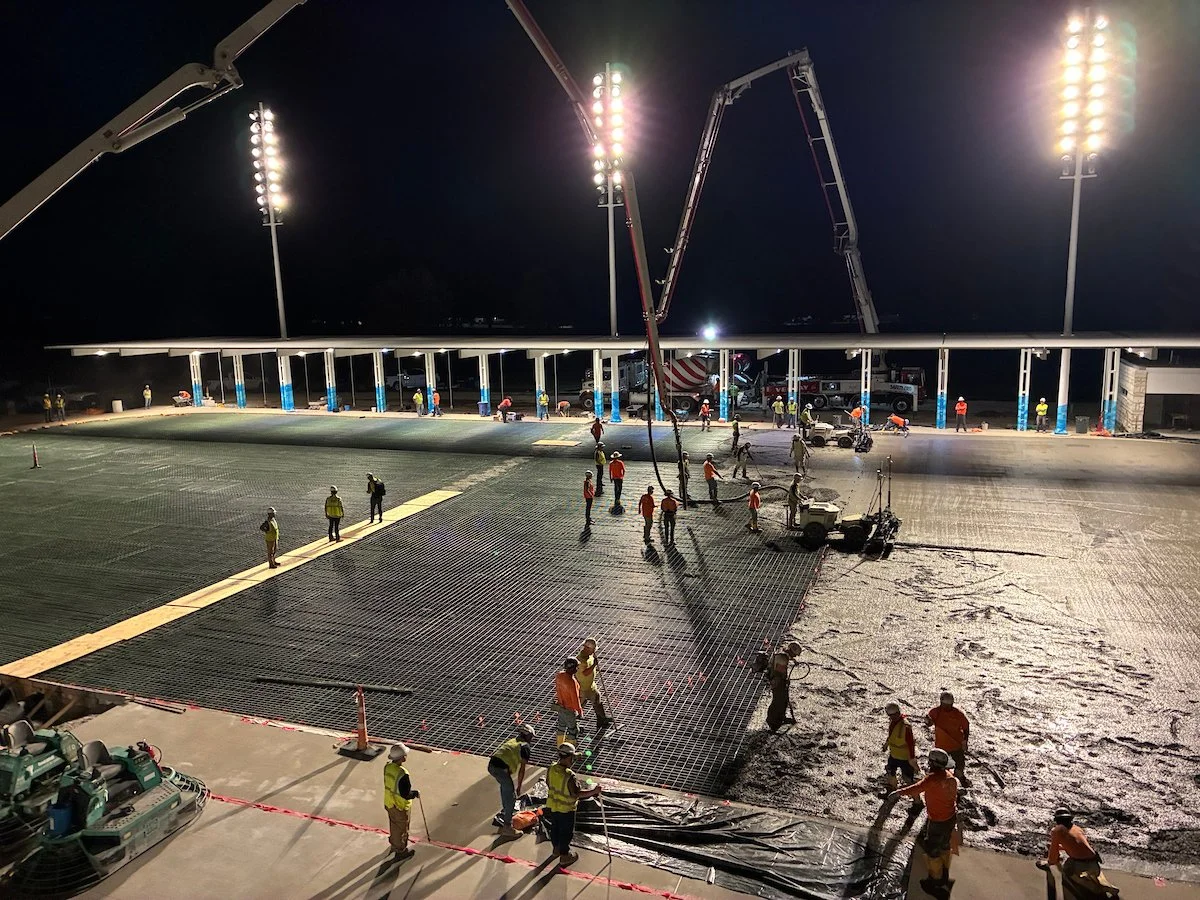

The temporary wood forms for the rink’s base are in place, ready for concrete to be poured.

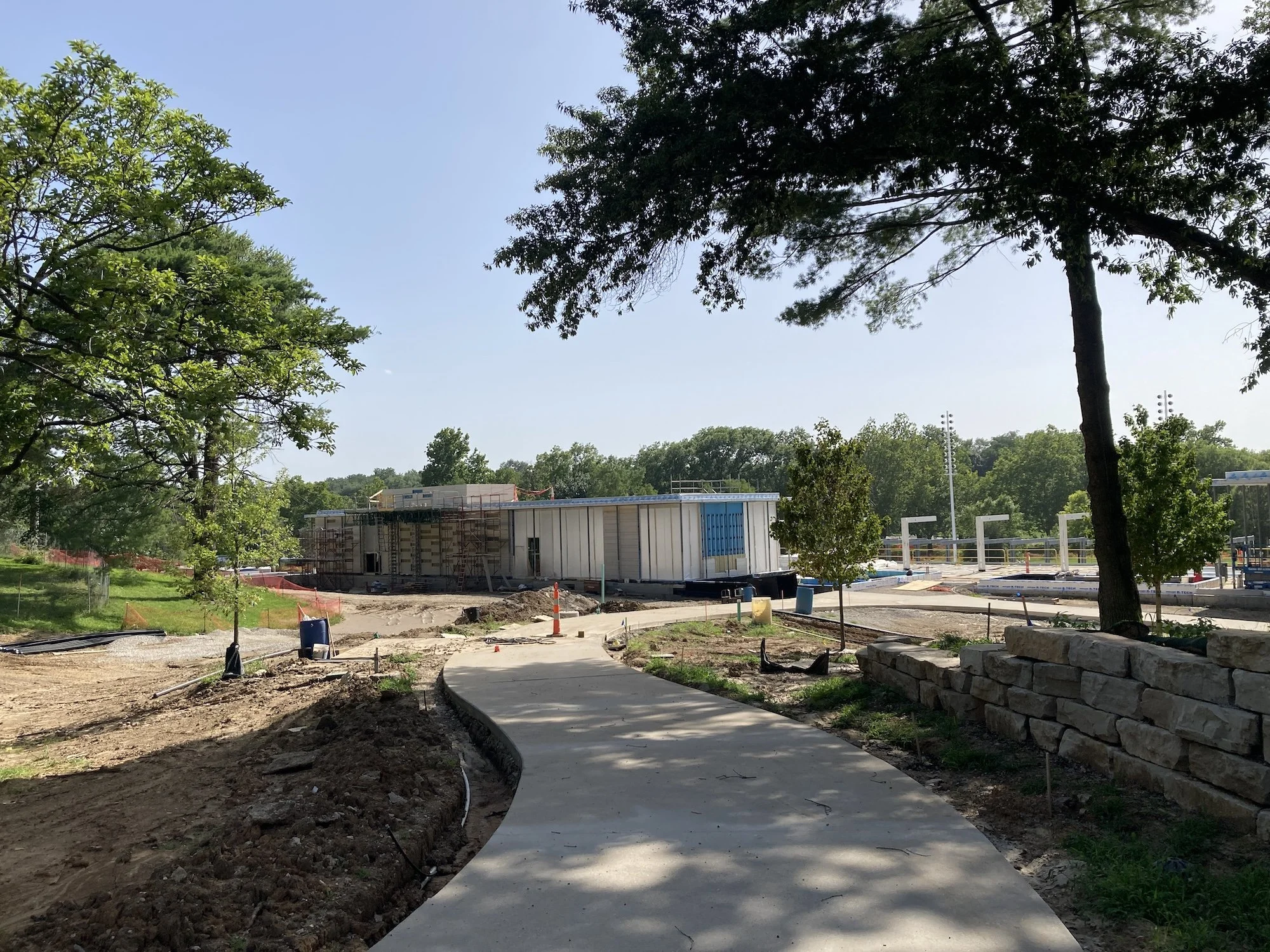

We’ve installed rink lighting and completed the brand-new accessible pathway from Kingshighway to the Glade.

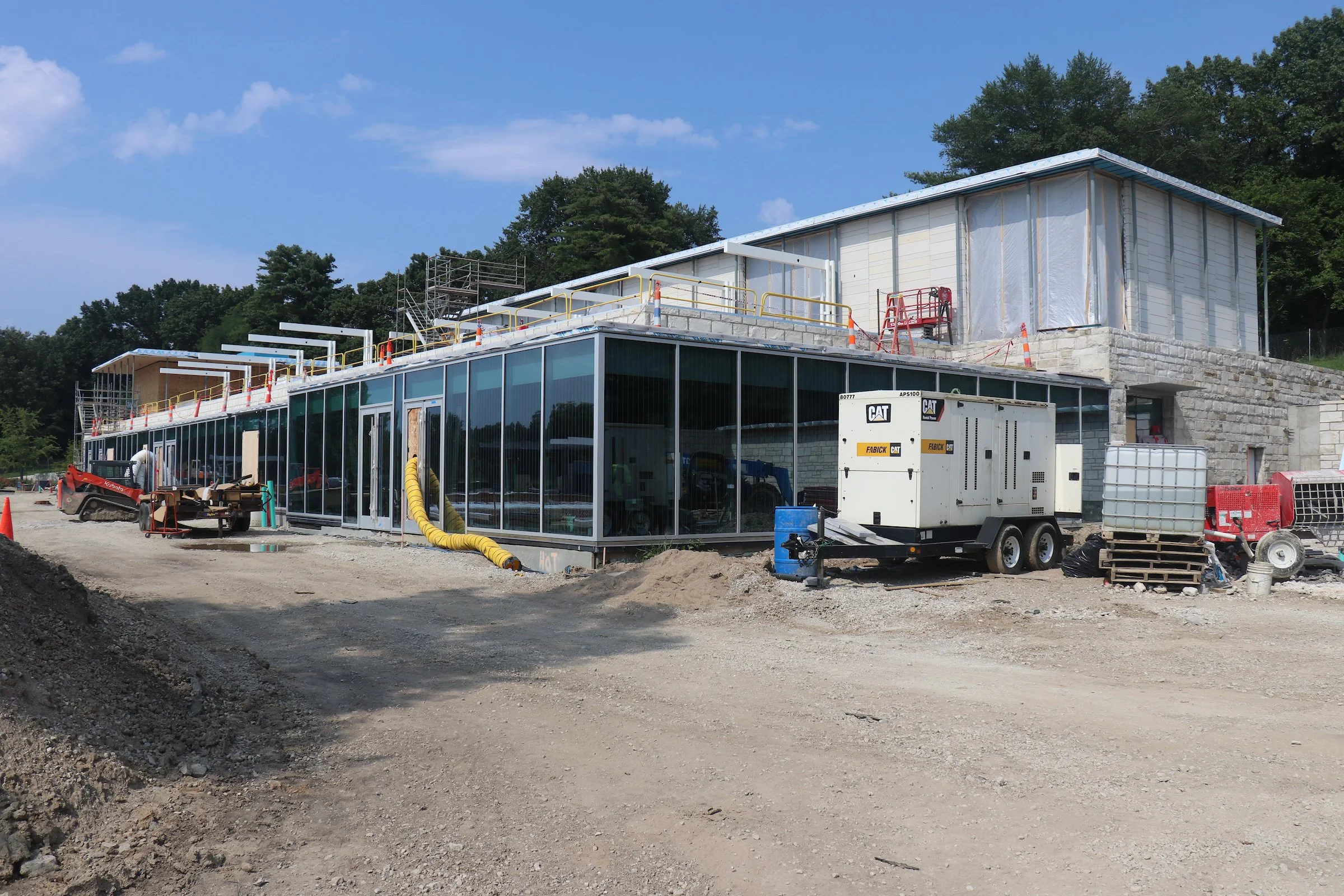

The historical façade of the Steinberg facility has been restored after workers removed, numbered and cleaned each limestone block before replacing it in its original position.
On the new second story, the beams for the rooftop terrace shade structure are in place.
-
Work that continued through the winter signaled exciting progress toward a finished space.

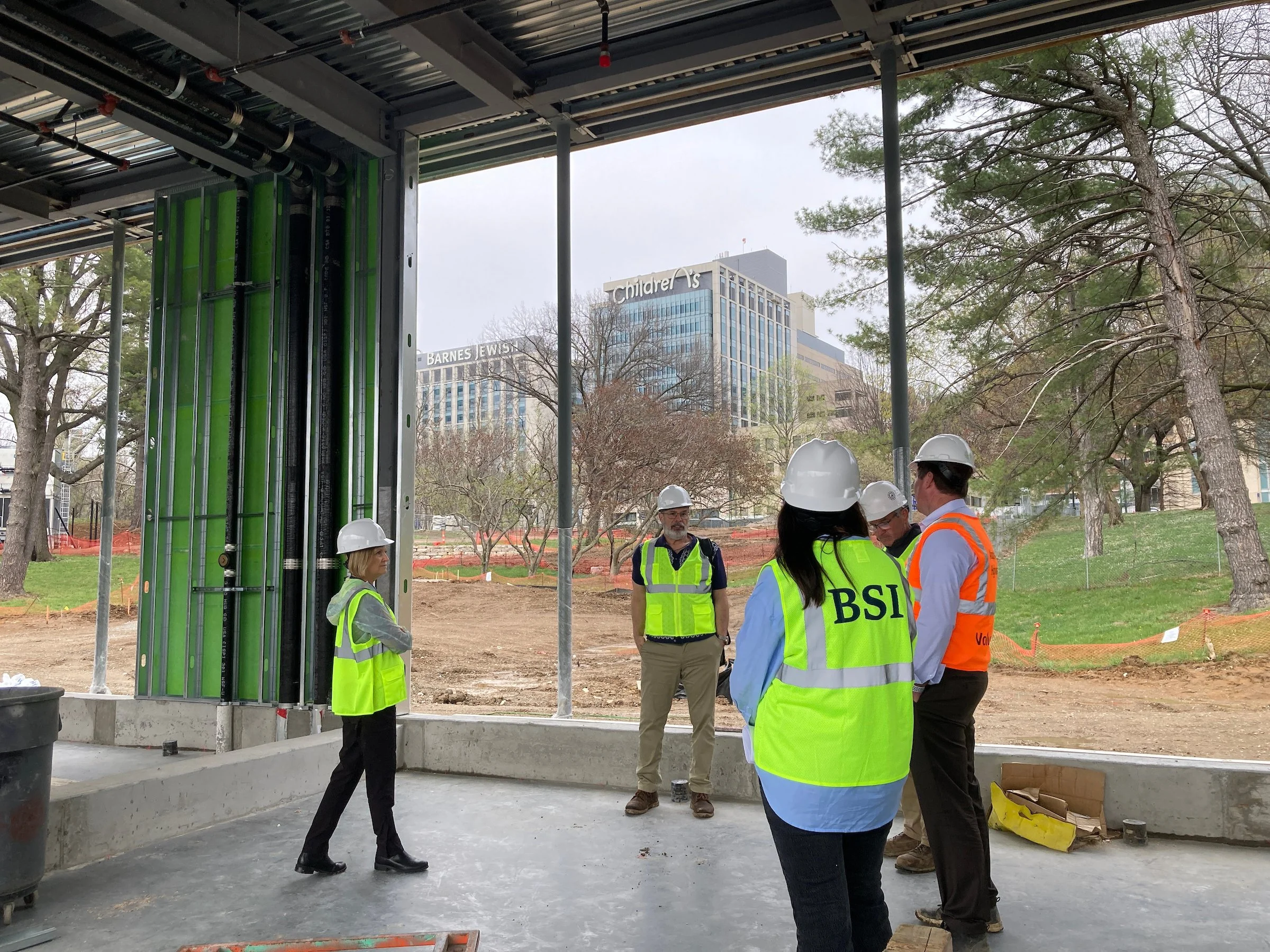

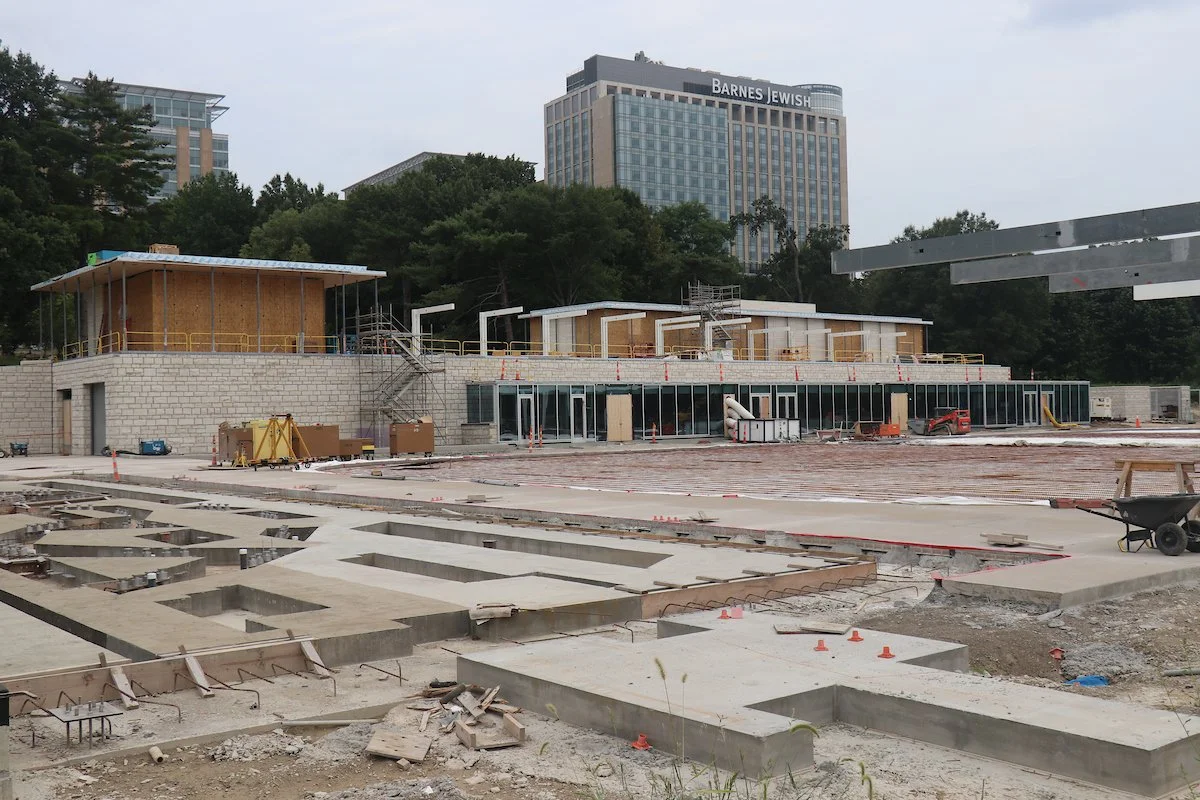

Drywall and insulation work began on the first floor of the renovated building.
Decking and vertical steel beams for the second story were raised, providing shape for what will be the rooftop restaurant at the south end of the building and community living room at the north end.
West of the rink, all cantilevered beams forming the roof of the shade structure were raised and spliced together on site.
Concrete girders forming the base of the pedestrian bridge over the Taylor Kindle River were placed and the base of the bridge was poured.
Construction progressed on the ADA-accessible serpentine path from Kingshighway that will connect the Glade to the WashU Medical Campus, Barnes-Jewish Hospital and the Central West End neighborhood.
-
Fall saw exciting advances in construction that are more visible to passersby.
Concrete poured for the new of the building extending into the hillside
Steel beams installed as the new roof and second story began to take shape
Soil excavation completed as part of preparation for pouring the foundation of the interactive water feature
Demolition of the old recreational path west of the site to make room for the Community Lawn
Site preparation and drilling for the new pedestrian bridge across the Taylor Kindle River
-
Summer was all about laying the foundations for the many amenities in this space.
Demolition and removal of parking lot pavement followed by installation of the geothermal well field
Demollition of old rink material and excavation of subgrade for new rink
Installation of micro-piers for the building and footings for the rink-side shade structure
Preparation of hillside for chiller unit concrete pad and installation of the chiller unit
The site's geothermal system won a 2025 Technology Award from the St. Louis Chapter of ASHRAE. Our conservancy will rely on this new system to recapture heat and reduce environmental impact season after season.
Coordinating with local furniture maker Mwanzi Co. to repurpose trees felled by the May tornado into tables and other furniture at the Glade.
Excavation and forming for the vault that will power the splash pad and cascade
-
Last spring, we closed the site and began decommissioning of the facility in preparation for this major transformation in eastern Forest Park.
Closing the site to the public and installing construction fencing
Toppling the large masts that supported the stadium-style lights on the west side of the rink
Demolition inside the building
Removal of pavement and relocation and storage of the Zamboni ice resurfacing vehicle
Pruning and/or removal of trees that are not part of the finished project. (Overall, 150 new trees will be added during the project.)
Decommissioning of the building and rink, including removal of salvage items from the building and removing refrigerant from the existing ice refrigeration system
Removal and preservation of Steinberg Rink lettering and limestone veneer from the building and site walls
Excavation of the hillside to the east of the Steinberg building
Continued removal and crating of the limestone veneer, which will be refurbished and reinstalled
Beginning of demolition of the roof slab and demolition of the east wall and ceiling of the building
Image Gallery

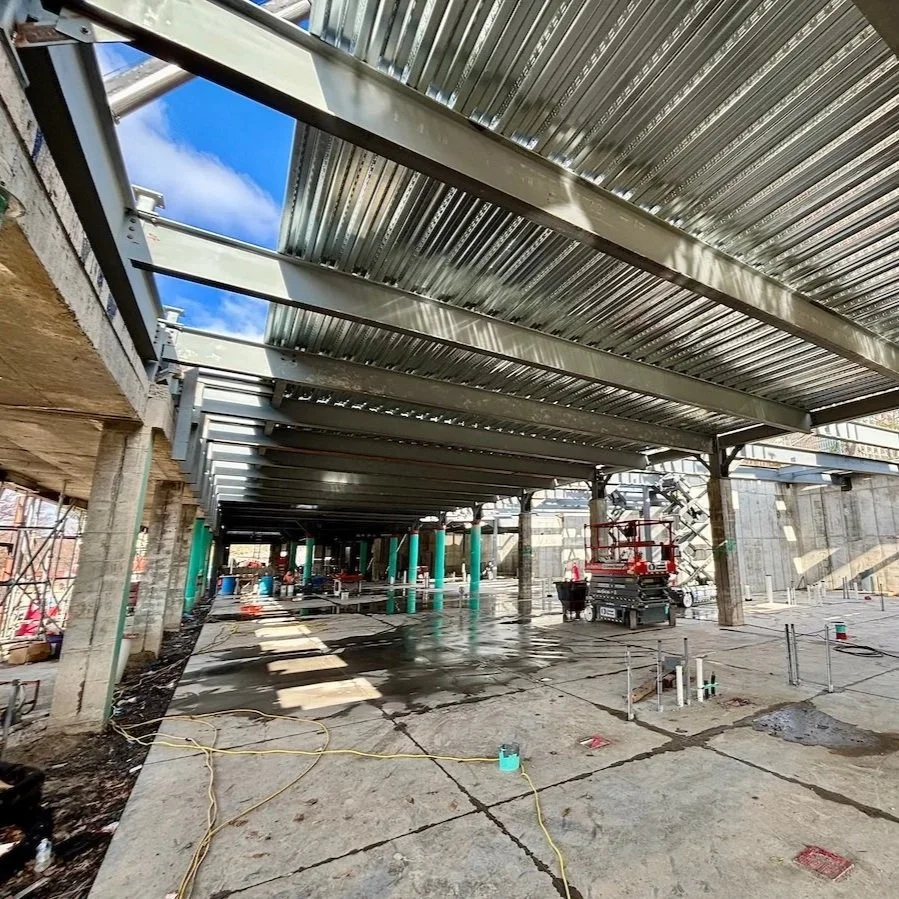

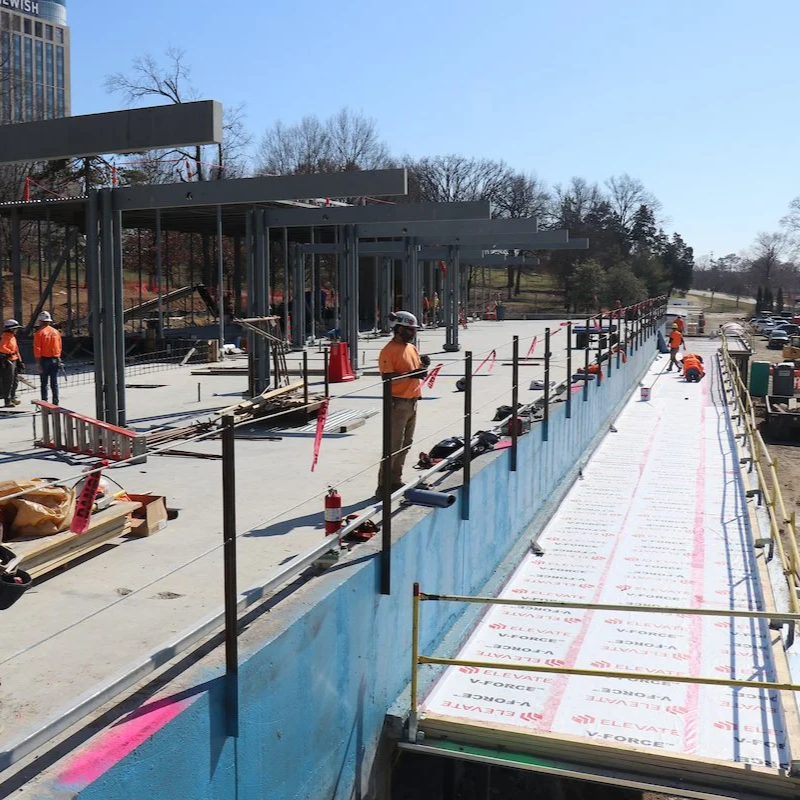

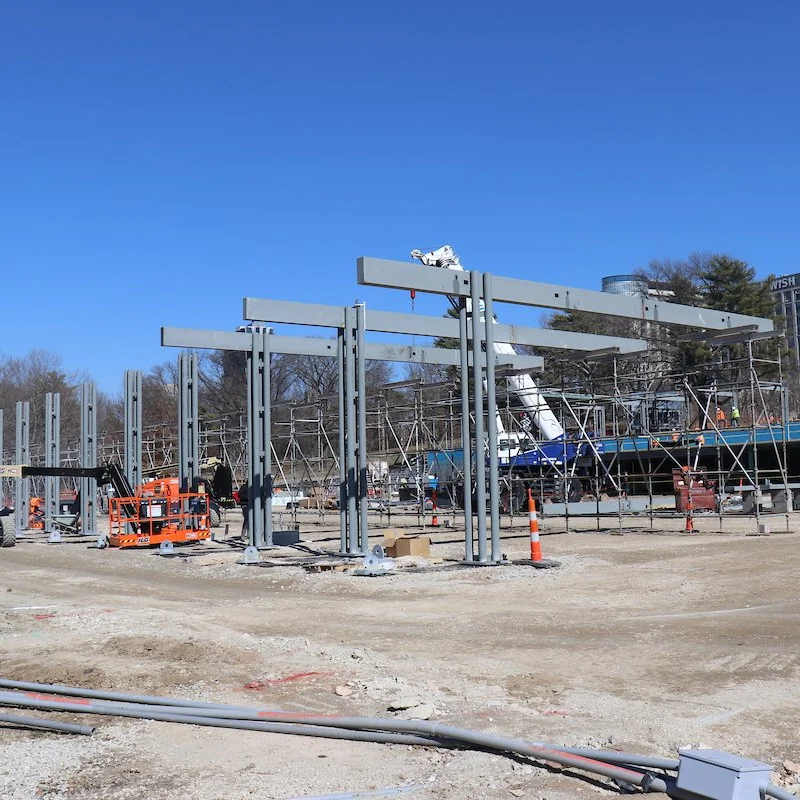

Images above from winter 2026 show steel beams of the nearly completed first-story ceiling, the all-new second story that will house the community living room and rooftop dining space, cantilevered beams forming the roof of the shade structure west of the rink and the girders for the new pedestrian bridge over the Taylor Kindle River.

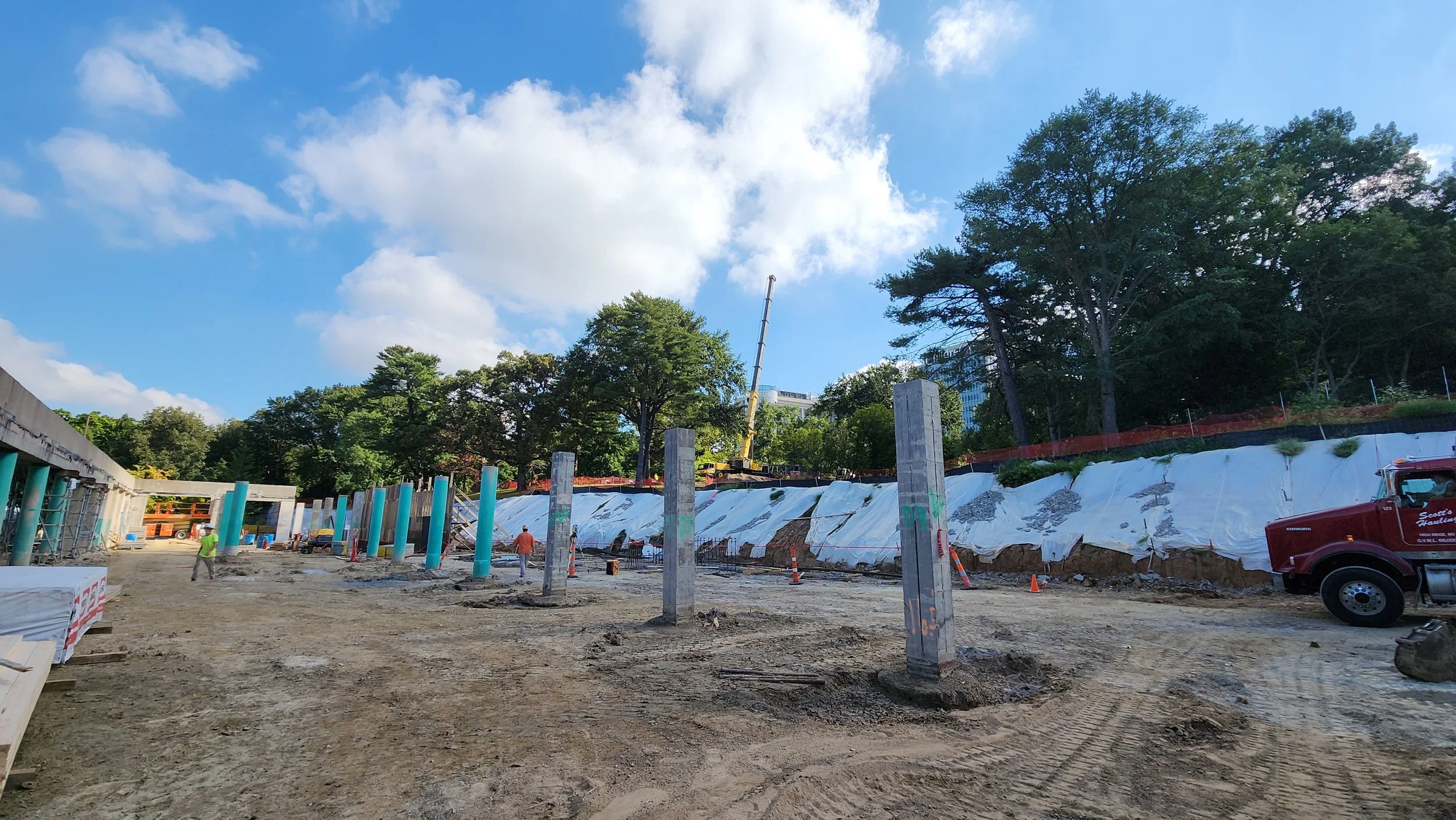

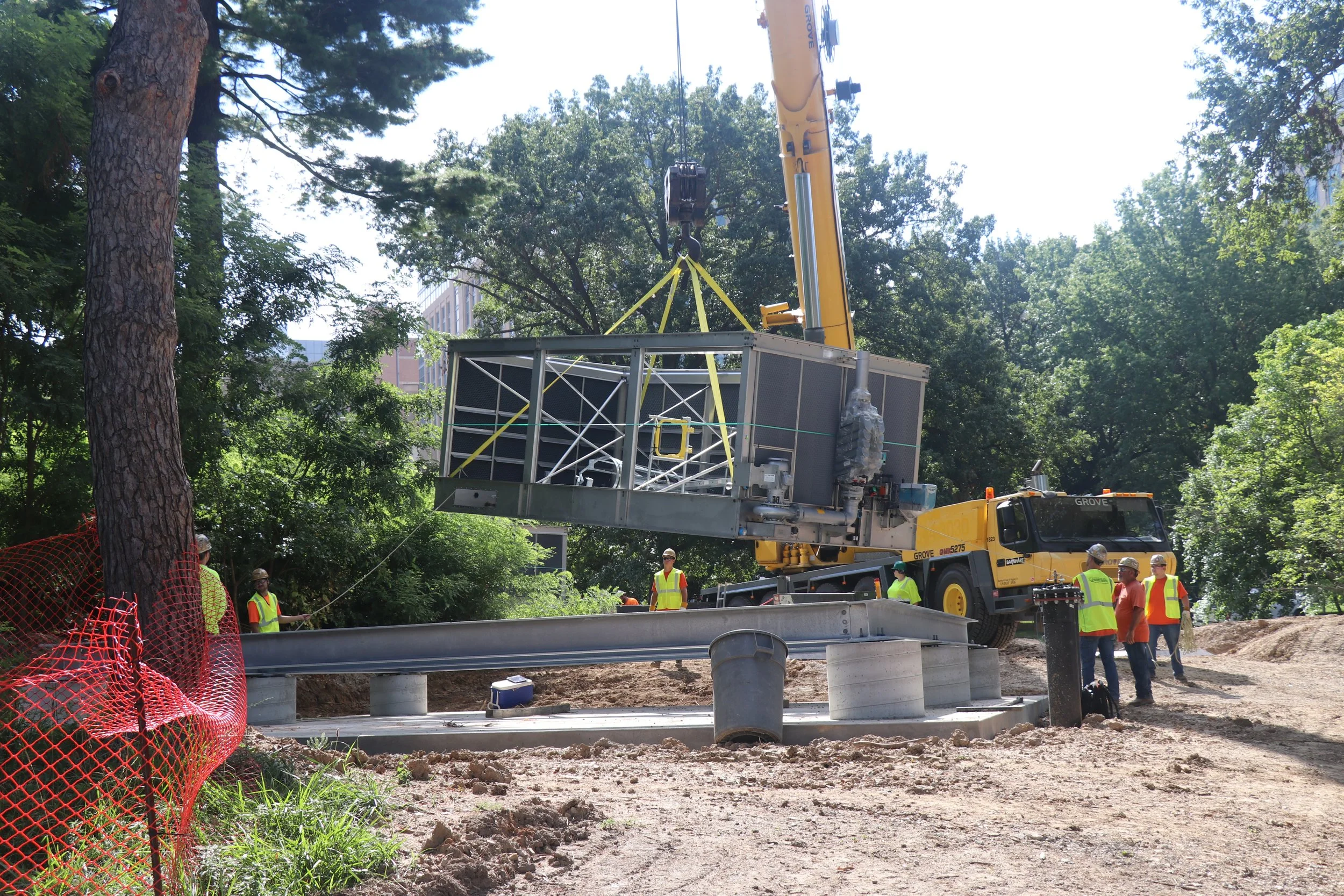

Images above from July and August 2025 show the deep-earth drill creating geothermal wells and concrete, installation of the hillside chiller unit and steel beams shaping the second-floor community living room.

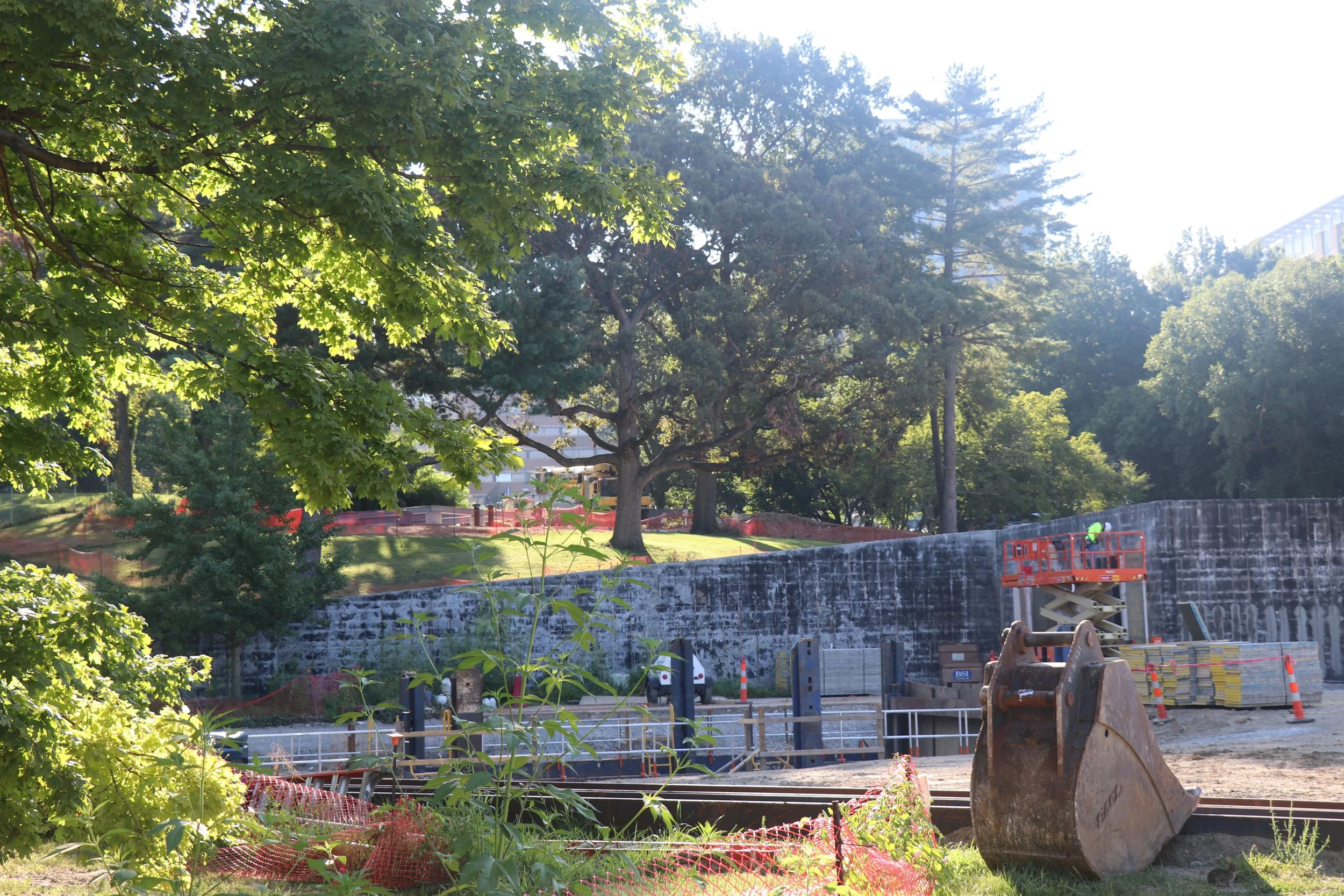

Images above from spring 2025 show demolition and removal of parking lot pavement and old rink material and excavation for new ice rink.

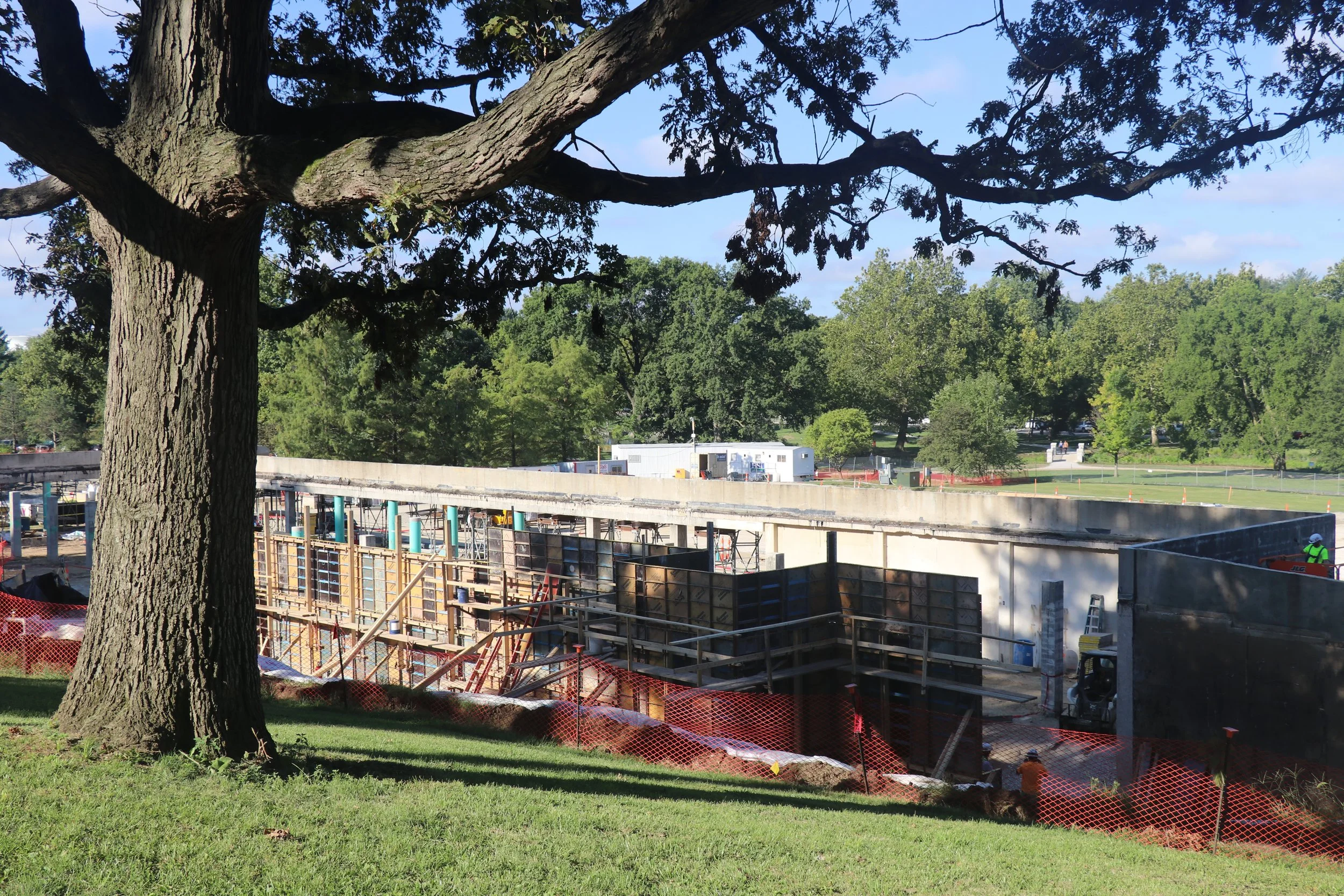

Images above from spring 2025 show removal and crating of the limestone veneer and excavation of the hillside to the east of the building.
